A single unreviewed revision to a drawing can repercuss through a Bill of Materials (BOM), stalling a production line, and triggering a recall six months down the line. Engineering change management is the structured process that prevents ripple effects by governing how a product’s design, documentation, and specifications are altered after the baseline is approved. This process maintains traceability, cost control, and delivery commitments. What is engineering change management, and how is it applied? This discipline ensures that every proposed modification turns into a tracked request, resulting in a formal decision and controlled notifications. That way, every change made on the shop floor is thoroughly evaluated, approved, and communicated. When executed effectively, this discipline can shift the perception of engineering change management from a compliance obligation to a strategic asset that safeguards profit margins.
What is engineering change management?
Engineering change management is the governed process for requesting, evaluating, approving, and implementing any modification to a released product’s design, documentation, or bill of materials. It exists to prevent uncontrolled changes, which exact a double cost: once in the rework they cause, and again in the trust lost when a customer or auditor discovers an undocumented deviation.
Engineering change management definition aside, the term is worth distinguishing from what is change management in the general organizational sense: general change management addresses how people adapt to new tools or structures, while engineering change management addresses a narrower, technical question: how a specific drawing, part number, or specification moves from one approved state to another without losing traceability. Every mature engineering change management system rests on three linked documents: the request, the order, and the notice.
Not sure where your process stands?
The engineering change management process: ECR, ECO, and ECN
Every disciplined engineering change management process runs on a three-stage sequence, and confusing the stages is the single most common source of delay.
An Engineering Change Request (ECR) opens the cycle. What is an ECR? It is the formal record of a proposed modification: what is changing, why, and what triggered the request, whether a field failure, a cost target, a supplier substitution, or a manufacturing difficulty. A well-written ECR names the affected parts, states the reason in one sentence a non-engineer could understand, and stops short of prescribing the solution before the review has happened.
Once a change advisory board, more on that shortly, reviews and approves the request, it becomes an Engineering Change Order (ECO). What is an ECO? It is the authorized instruction: the specific drawings, part numbers, and BOM lines that change, the effective date, and the disposition of existing inventory: use as is, rework, or scrap. The ECO is the document a manufacturing or quality team can act on with confidence, because it carries an authorized decision.
The final stage is the Engineering Change Notice, sometimes abbreviated as ECN or referred to as an Engineering Change Notification in some organizations. ECN meaning, precisely: it is the broadcast that tells every affected function- procurement, manufacturing, service, and often the customer- that an approved change is now in effect and by when. Skipping this step, or sending it late, is why organizations discover a part number mismatch on the receiving dock rather than in a review meeting. Seen together, the differences between the three stages, and who owns each one, become clear:

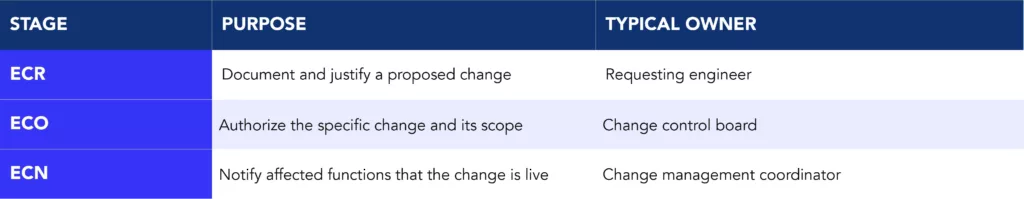

Table 1 – ECR, ECO, and ECN: stages, purpose, and owners
Treat the ECR, ECO, and ECN processes as three distinct disciplines, each with its own output. Organizations that collapse them into a single, loosely defined change process eventually cannot answer a straightforward question: which revision shipped to which customer on which date.
Who governs the process: change control boards and roles
A change control board, often called a change advisory board depending on the organization’s vocabulary, is the cross-functional group that decides whether a proposed change proceeds. Its composition should mirror the change’s blast radius: engineering, quality, manufacturing, and procurement at minimum, with finance and service added when cost or field support is affected.
Clear change management roles and responsibilities prevent the board from becoming a bottleneck. The requester owns the change request form or change request document and answers technical questions. A designated reviewer confirms the request is complete before it reaches the board, so meeting time goes to deciding. The board itself makes only one decision: approve, reject, or return for more information, on a fixed, recurring cadence.
For changes with unclear or competing priorities, a weighted decision matrix, sometimes called a decision analysis matrix, gives the board a structured way to score options against cost, schedule impact, quality risk, and customer impact. This single tool compresses engineering change management cycle time more than any software purchase, because it replaces debate with a documented, defensible comparison.
Configuration management, document control, and the BOM
Configuration management is the discipline of knowing, at any moment, which revision of which part is authorized for which product, and it is what keeps engineering change management from collapsing under its own volume as a product line matures. A configuration management plan defines how revisions are numbered, how obsolete versions are retired, and how the record stays synchronized across engineering, manufacturing, and service.
Document control is the closely related discipline of ensuring the authoritative version of a drawing, specification, or work instruction lives in exactly one place, with everyone working from that single current version. A document control process that cannot answer which version is current within seconds is not controlling anything.
Revision control ties both disciplines together at the part level, and product configuration management extends the same logic to how those parts combine into a finished assembly. This is where the BOM becomes the load-bearing document for the entire process: every engineering change order ultimately translates into a change to one or more BOM lines. BOM management done well means an approved change updates every affected BOM level automatically, without a separate manual edit at each tier, a distinction that matters even more when a change reaches beyond the drawing and into industrial layout or line sequencing on the shop floor.
Root cause analysis, corrective and preventive action (CAPA), and why changes happen
Most engineering changes do not originate from an engineer’s ambition. They originate from a nonconformance: a defect found in the field, a supplier deviation, or a quality escape that nonconformance management flagged before it repeated. Treating the ECR as disconnected from that upstream nonconformance is a common and costly mistake, because it severs the change from the evidence that justified it.
Root cause analysis is what earns a change the right to exist. A 3C approach, naming the concern precisely, verifying the cause with evidence, and defining a countermeasure that addresses that cause, produces engineering change requests that survive board scrutiny on the first pass. Skipping this discipline is why so many CAPA programs produce processes full of changes that treat symptoms and see the same failure recur within a year.
Before authorizing the fix, technical feasibility and change impact analyses confirm that the countermeasure operates within real manufacturing constraints and does not compromise form, fit, or function elsewhere in the assembly. Done properly, this sequence- verified cause, feasible countermeasure, assessed impact- delivers durable cost reduction: less scrap, less warranty exposure, and fewer repeat failures competing for the same engineering capacity.
Product lifecycle management (PLM), product data management (PDM), and the digital thread: where ECM software fits
PLM platforms exist to give engineering change management a system of record, and the distinction between PLM software and a PDM system is worth being precise about. PDM systems manage files such as Computer-Aided Design (CAD) models, drawings, and their revisions. PLM extends that scope across the entire product life cycle, connecting design data to sourcing, manufacturing, and service. Purpose-built engineering change management software, whether delivered as a module inside SAP engineering change management workflows, a Windchill change management configuration, or a standalone engineering change management system, automates routing, approval tracking, and notification so a change does not stall over a missed email.
The architecture reshaping this space is the digital thread: a live, model-based enterprise link between the 3D model, the BOM node it defines, supplier data, and the manufacturing instructions built from it, replacing a paper trail of disconnected documents. Digital twin manufacturing extends that thread into production, allowing a team to simulate a proposed change on a virtual model of the line before committing to a physical first-article inspection. None of this software replaces judgment. What it does, increasingly with AI-assisted triage layered on top, is compress the distance between a change request and an informed decision: impact analysis that once took a week of cross-referencing spreadsheets now arrives as a synthesized summary the board can review in a single sitting. The engineering change management software still needs a disciplined process behind it, because a fast system that routes an undisciplined change simply produces undisciplined change faster.
Get the process right before you scale it with software
Building an engineering change management process that scales
An engineering change management process that scales treats change as a value stream to be measured and improved. Mapping that value stream exposes where changes actually stall: usually in the handoffs between functions.
A handful of engineering change management best practices apply regardless of industry: keep each ECR scoped to a single change rather than bundling several, set the Change Control Board (CCB) to a fixed weekly or biweekly cadence, and standardize the change request form so reviewers know exactly where to look for cost, schedule, and quality impacts. A visual change management workflow diagram, posted where the team can see it, does more for cycle time than another field added to the form.
The stakes scale with context. An engineer-to-order process depends on ECM engineering discipline for every custom build, because there is no stable baseline to fall back on if a change is mishandled. A regulated quality management system, ISO 9001 change management requirements included, and any environment governed by process safety management treat the ECM process as an audit trail. Get the process right, and time-to-market reduction follows as a byproduct: fewer stalled changes means fewer delayed launches. A plant’s maintenance strategy types intersect with ECM here too, since a change to a part or a machine setting often changes the maintenance task required to keep it running.
Change management is a discipline, not a tool
Engineering change management rewards the same discipline that improves any operational process: a clear standard, a mapped value stream, and a governance rhythm people trust. Software will keep getting faster at surfacing impact and routing approvals, but it cannot substitute for a CCB that meets on schedule or an ECR that names a verified root cause.
Kaizen Institute has spent decades helping engineering and quality teams turn exactly this kind of process, built from small, disciplined habits sustained over time, into a durable capability. Organizations ready to build that capability internally often start with structured change-management training for the people who will serve on the board.
That same discipline extends upstream of the baseline itself: how a product is developed before release shapes how many changes it generates afterward, which is where lean product development consulting applies the same mapped-value-stream logic described above. For the change control board and its decision rhythm this article describes, KAIZEN™ Culture consulting turns those routines into how the team works, and Business Transformation training builds the people who staff the board.
Still have some questions about engineering change management?
What should an ECR template include?
An effective ECR template captures the part or document affected, the reason for the change, the requester, and a field for the change control board’s decision, keeping the engineering change order template that follows consistent with it so nothing is re-entered by hand.
Are the ECN, ECO, and ECR processes the same thing?
No. Each is a distinct stage with its own owner and output: the ECR process documents a proposal, the ECO process authorizes it, and the ECN process communicates that it is live. Treating them as one blurred ECM process is the fastest way to lose traceability.
Does engineering change management apply outside manufacturing?
Yes. The same governed-change logic applies to regulated construction projects, where change management governs drawing revisions and site variations under comparably strict documentation requirements.
